This article explains why and how to create a Kanban and sprint-based report using the Board’s action menu for Company-managed spaces.
What are the advantages of using sprint-based reports?
-
This method is ideal when you need monitor dependencies for work items within a hierarchy, which belong to a single or to concurrent sprints,
-
A report based on a Board allows to track you much quickly work items that last multiple sprint, without leaving the Board navigation.
Features and use cases
How can you create a Kanban or a Scrum board report?
You can create a report for work items on a Kanban board or for sprints on a Scrum board in Company-managed projects (formerly classic) by following the steps below.
For Team-managed projects (formerly next-gen), see the related article.
Using Kanban Board
Atlassian recommends a Kanban board for teams that:
-
Manage stories, tasks, and bugs in a continuous flow
-
Control work volume from a backlog
To create a report for a Kanban board:
-
From the Jira sidebar, click Spaces, select your space, and open its Kanban board.
Alternatively, use the search bar in the top navigation to find and select the Kanban board.
-
In the space navigation, select the Kanban board tab.
-
Open the actions menu (•••).
-

Click Pivot Report.
-

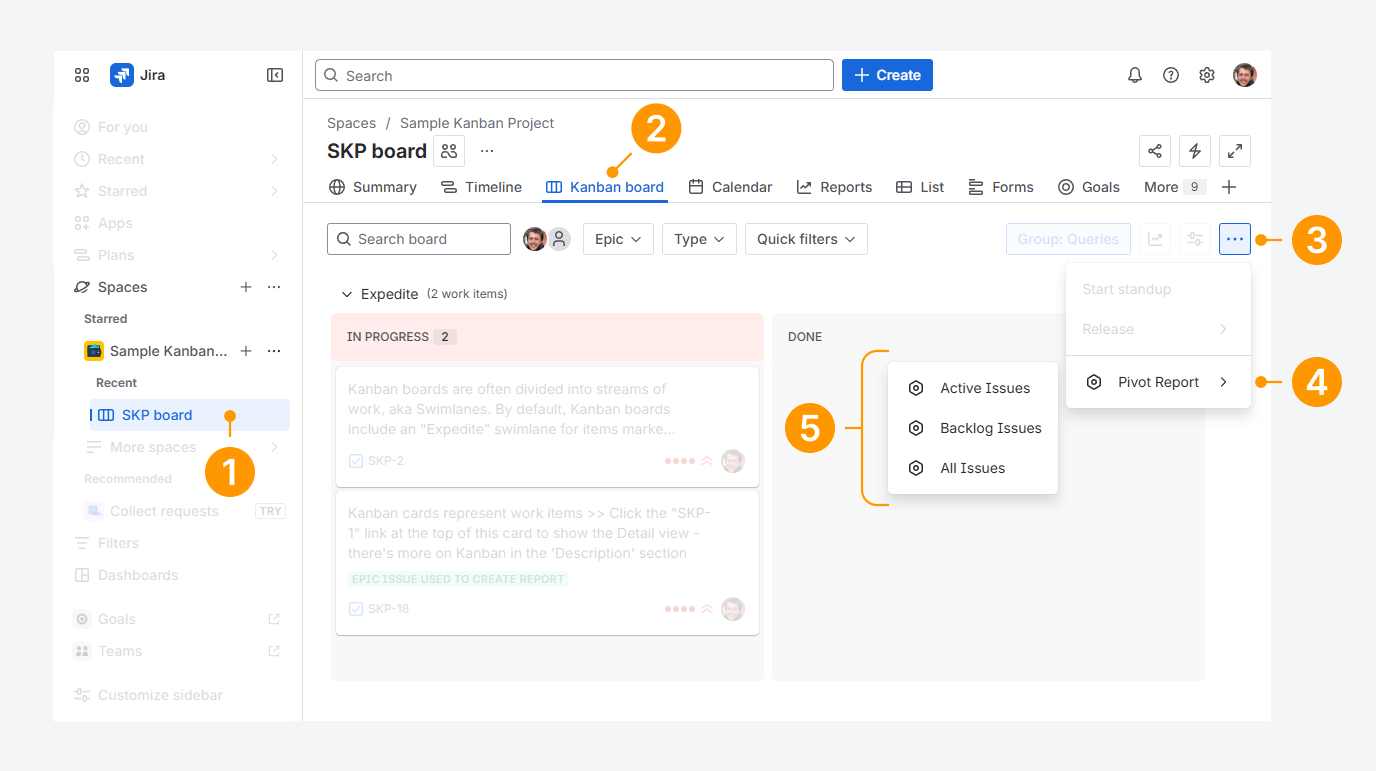

Select one of the three report options:
-
Active Work items: Generates a report for work items not listed in the Kanban backlog.
-
Backlog Work items: Generates a report for work items listed in the Kanban backlog.
-
All Work items: Generates a report for all work items.
-
Using Scrum Board
Atlassian recommends a Scrum board for teams that:
-
Manage stories, tasks, and bugs in sprints.
-
Deliver work on a regular schedule.
To create a report for a Scrum board:
-
From the Jira sidebar, click Spaces, select your space, and open its Scrum board.
Alternatively, use the search bar in the top navigation to find and select the Scrum board.
-
In the space navigation, select the Active sprints or Backlog tab.
-

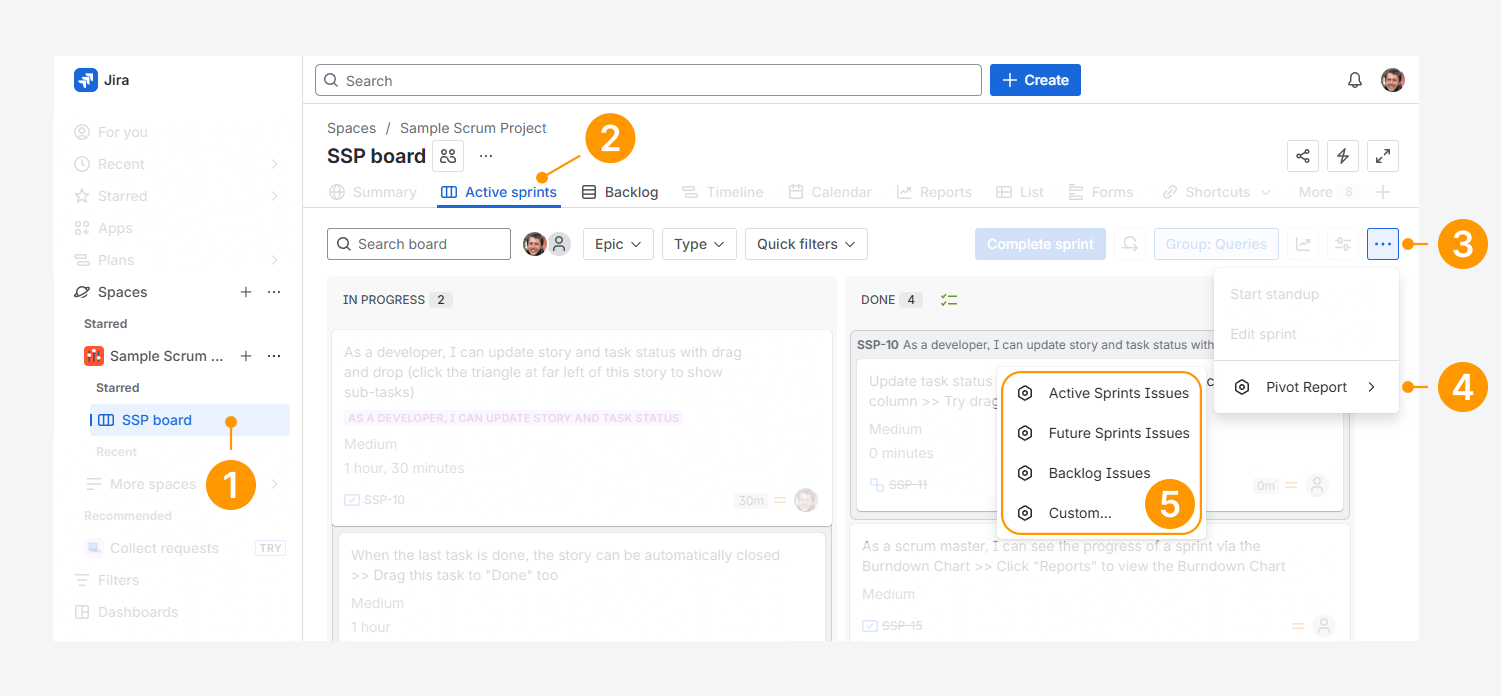

Open the actions menu (•••).
-
Click Pivot Report.
-

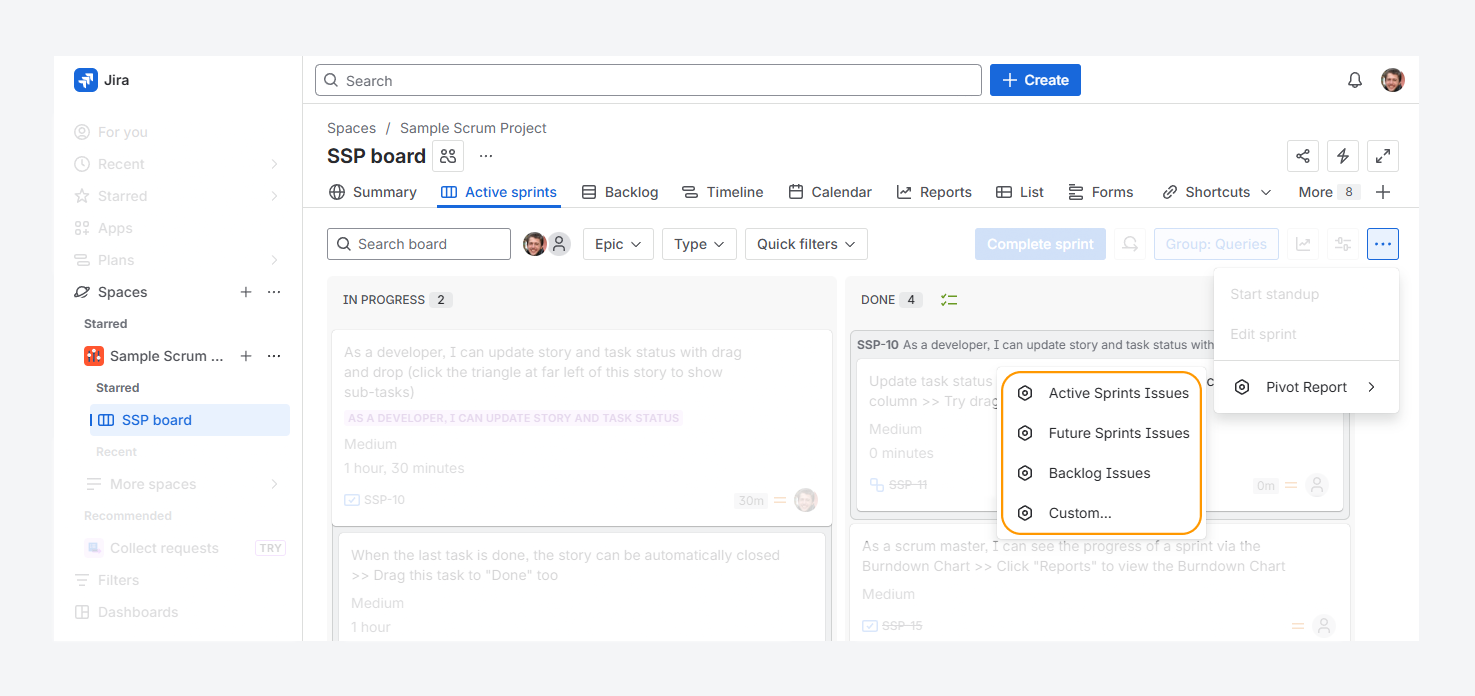

Select one of the 4 report options:
-

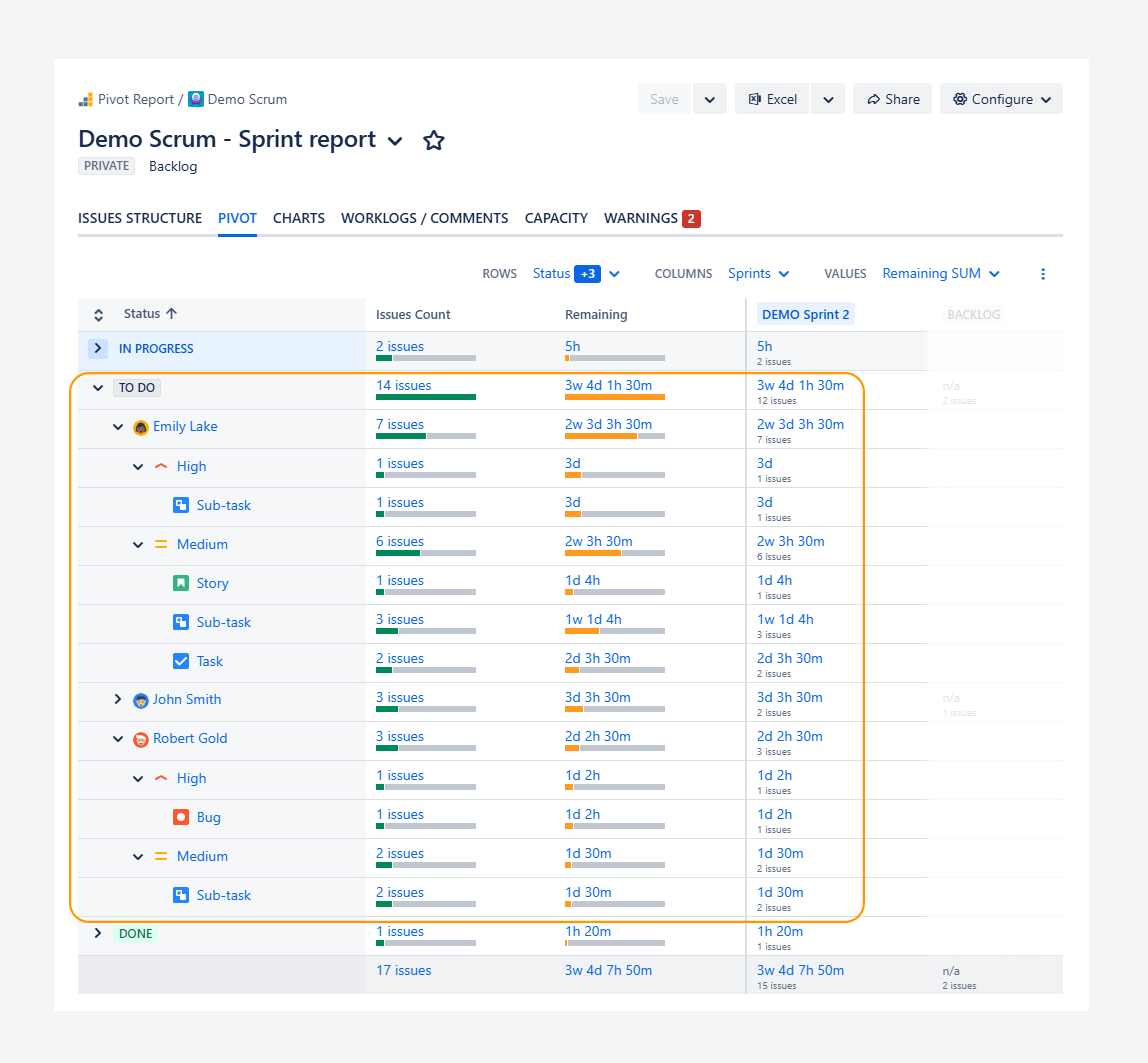

Active Sprint Work items: Generates a report for all work items in the active sprint (if one exists on the board).
-
Future Sprint Work items: Generates a report for all work items in upcoming sprints (if they exist on the board).
-

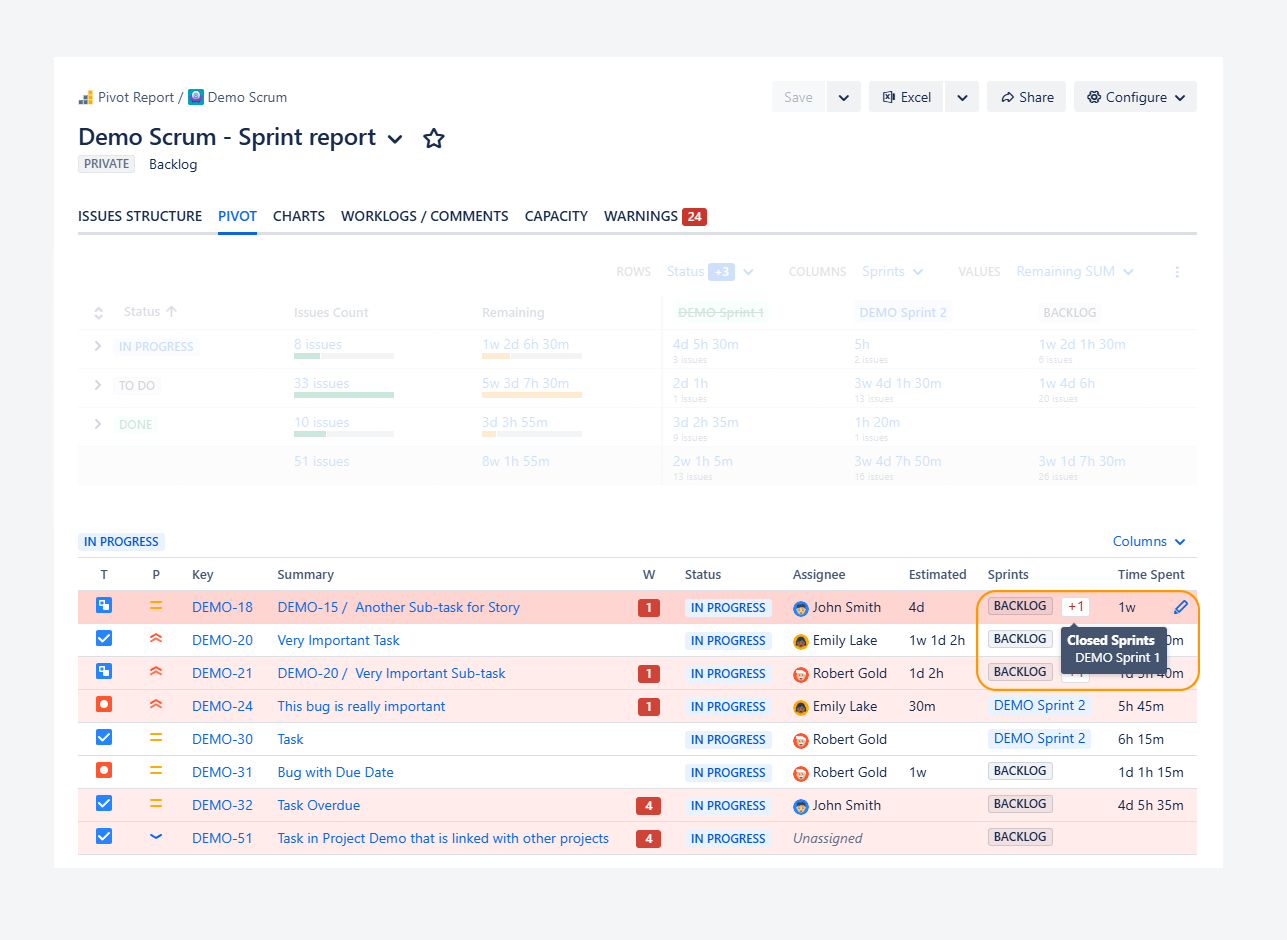

Backlog Work items: Generates a report for all active work items not assigned to an active or future sprint.
-

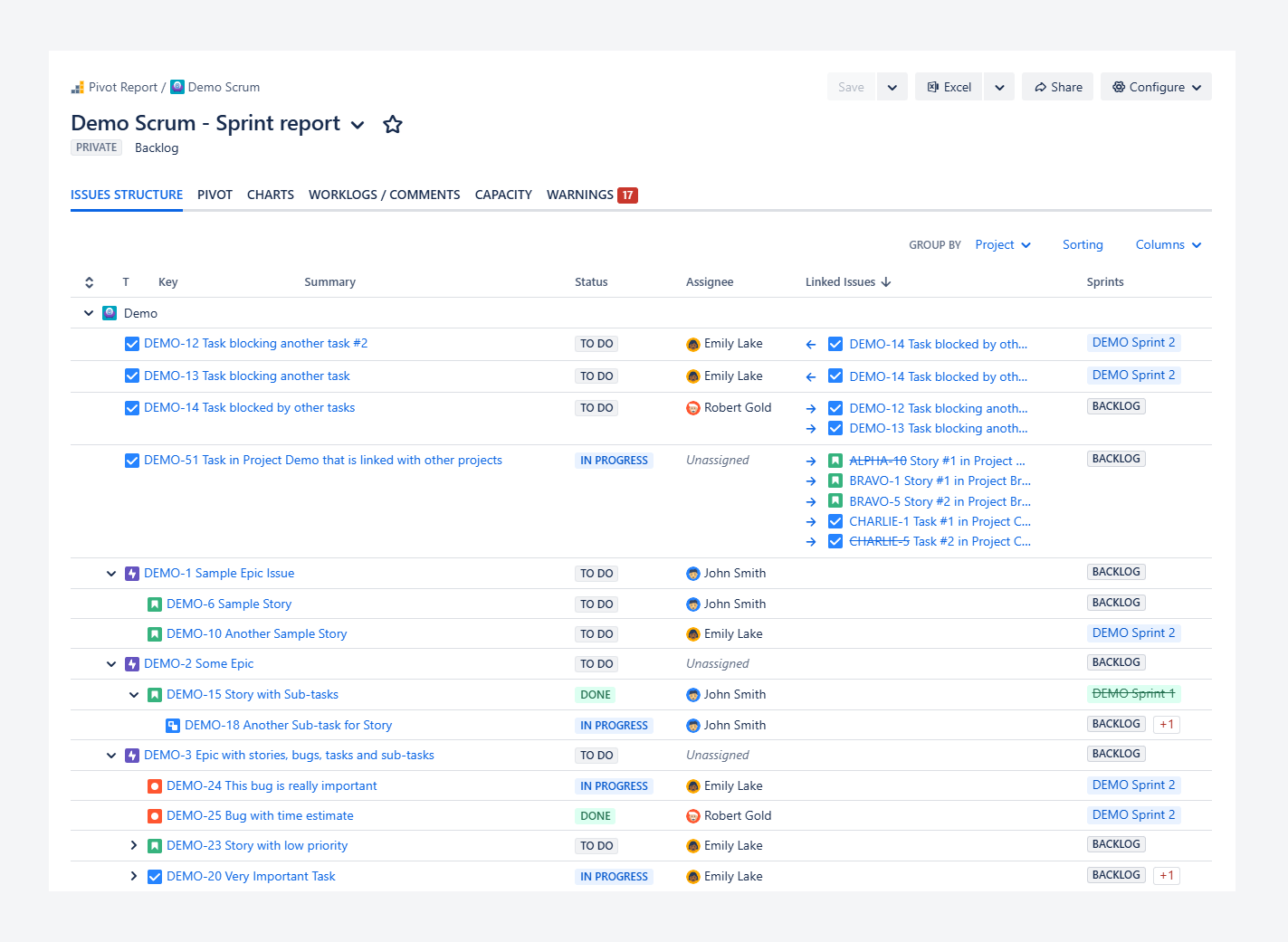

Custom: Opens a Pivot Report Options pop-up, where you can access additional settings.
Custom report options

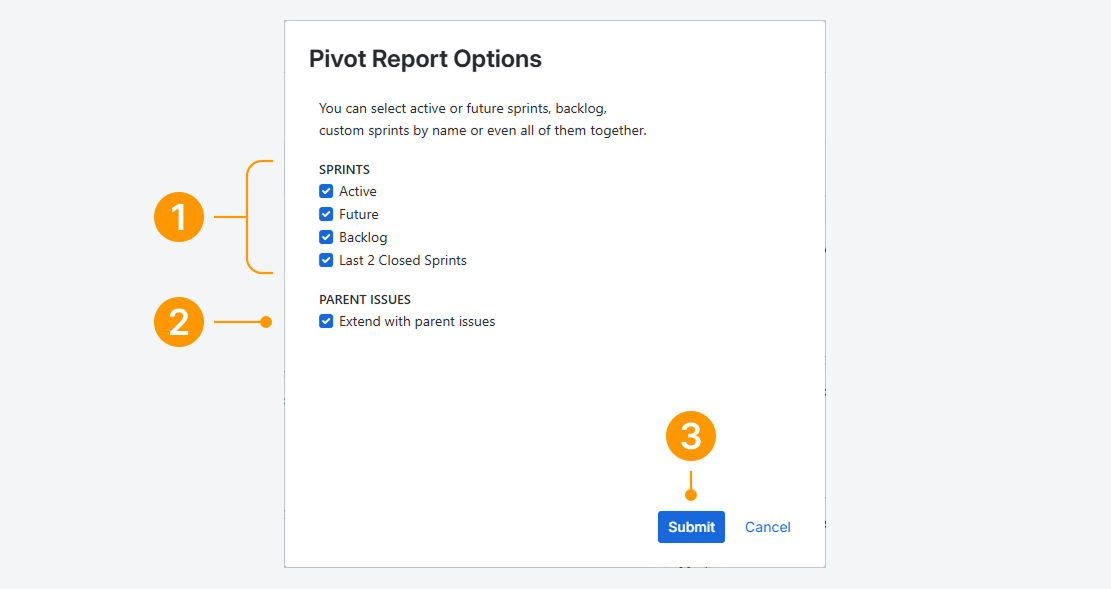

If you select Custom from the list of report options in Step 5, the Pivot Report Options pop-up appears.
-
Select the sprints from the board that you want to include in the report. By default, all four options are selected when the pop-up opens. You can clear any option to refine the report.
The available options are:
-
Active: Work items from active sprints (one or more)
-
Future: Work items from all future sprints after the active sprint
-
Backlog: All active work items not assigned to an active or future sprint
-

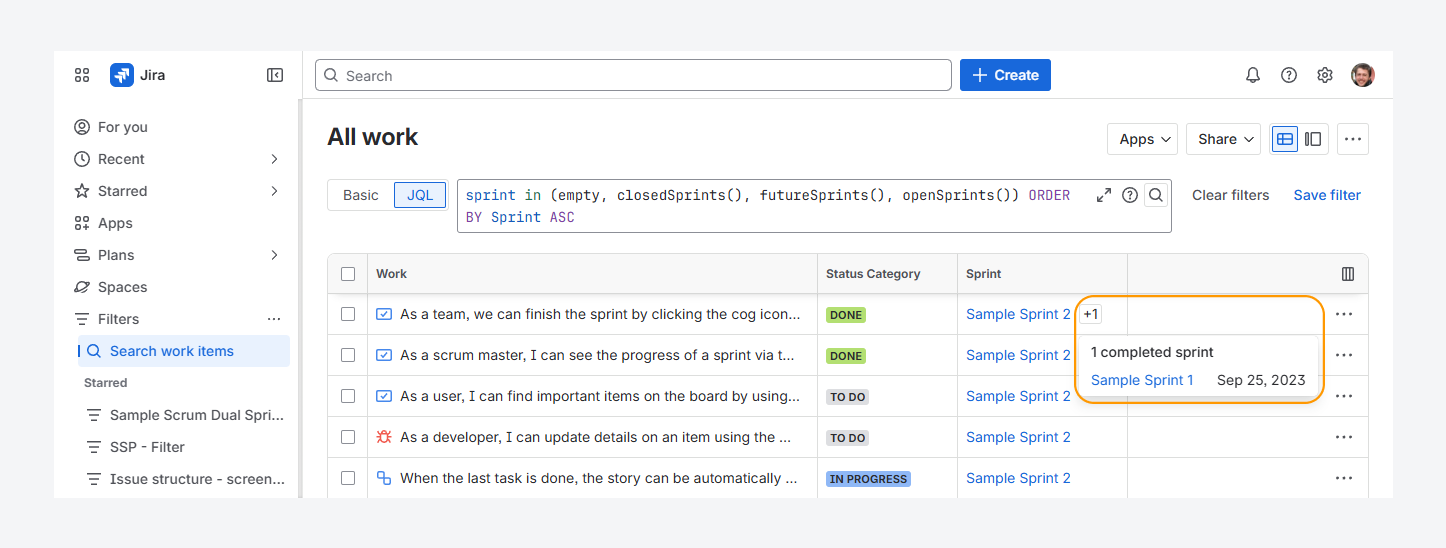

Last 2 Closed Sprints: Work items from the two most recently closed sprints
-
If needed, select the option to include parent work items to expand the report scope. Parent work items are described by Atlassian in a separate article.
-
Click Submit to apply your selections.
